How long do custom cabinets take
How long do custom cabinets take? For a standard kitchen or vanity program, the factory commitment is 10-14 days of production counted from confirmed drawings, followed by 18-22 days of duty-paid ocean transit to the US West Coast or 32-40 days to the East Coast. Closet and wardrobe systems run 12-16 days in the factory. If the program needs a custom door profile or colour, add a 7-10 day sample stage before the drawings are frozen. In practice that puts most orders four to five weeks door to door to Vancouver or the US West, and six to eight weeks to the US East.
Those are the committed numbers, and they are published on the factory page. What the committed number does not show is where the days actually go - which desk holds each stage, which days belong to you rather than the factory, and which parts of the calendar no amount of planning can move. This article lays that out stage by stage, using the same schedule our own project managers work to.
Two clocks: the commitment and the internal schedule
A factory runs on two different clocks, and buyers who confuse them end up either suspicious or complacent. The first clock is the committed lead time: 10-14 days for kitchen and vanity runs, 12-16 for closet and wardrobe systems, with the production slot confirmed in writing before any deposit is taken. The second clock is the internal schedule - the day allowance each stage of the order carries while it moves through the plant. Stages overlap, some run in parallel, and the committed number is what falls out the other end on a standard run.
The internal schedule matters most on custom programs, where the work is larger and the stages are quoted per project. Below is that schedule, the one our custom department measures against once drawings are confirmed.
Inside the factory: the stage-by-stage schedule

| Stage | Days | What happens |
|---|---|---|
| Order worksheet | 0.5 | Merchandiser turns the quote into a production order |
| Shop drawings | 1-5 | Engineering draws the confirmed design for your approval |
| Drawing review | 1 | A separate reviewer checks the drawings against the spec |
| Breakdown | 2-7 | Each panel is decomposed into cut lists and machine files |
| Material prep | 1-7 | Sheets pulled, graded and acclimatized; can start early when a job is urgent |
| Cutting | 1-3 | CNC sizing to the cut lists |
| Edge banding | 1-3 | Banding applied and end-trimmed |

| Drilling | 1-3 | System holes and hardware bores |
| Sorting | 1-3 | Panels matched to cabinets and rooms |
| Trial assembly | 3-7 | Every run assembled before packing |
| Inspection | 1 | Final QC, photos at 24, 48 and 72 hours during production |

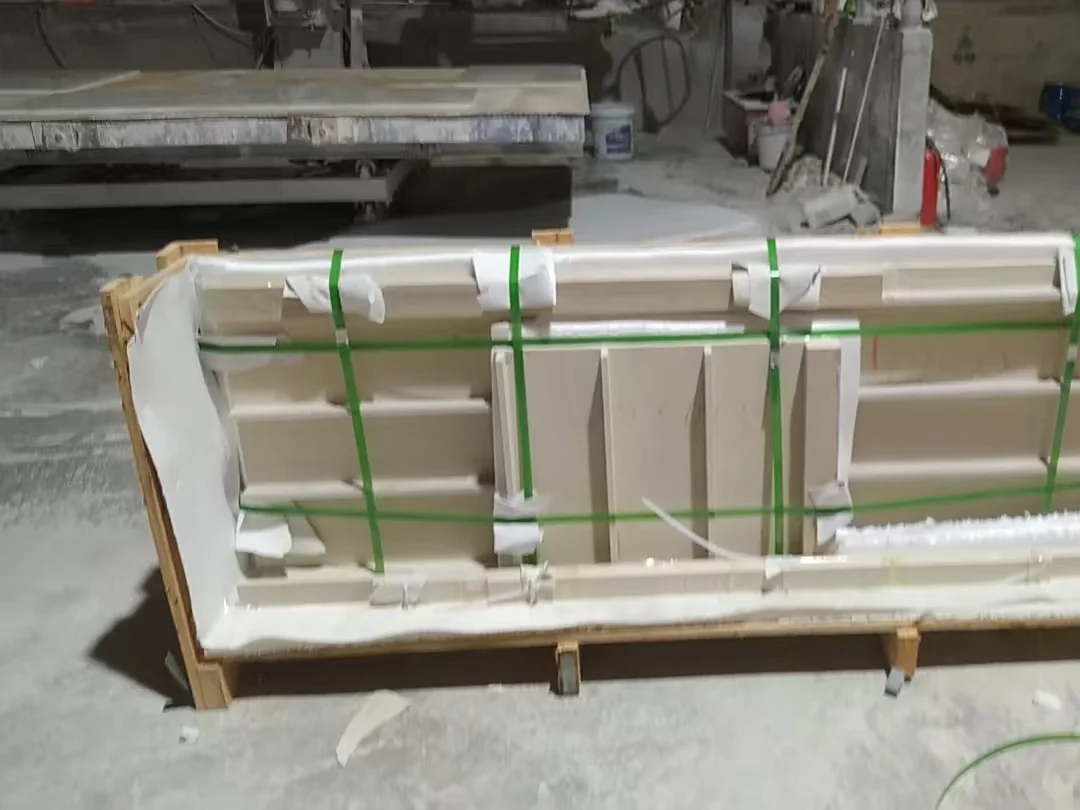

| Packing | 2 | Crating, corner protection, palletising |
| Packing list and export filing | 2-3 | Documentation and export inspection filing |
A few honest notes on that table. The 2-7 day allowance on breakdown is a ceiling our project managers chase hard - internal practice is to escalate any order still sitting there on day three. Material prep can be pulled ahead of breakdown when a schedule is tight, because board quantities can be estimated from the final drawings. And the export filing line hides the least predictable number in the whole chain: the inspection filing itself is 1-7 days, and in busy seasons it has stretched past ten. That stage belongs to the paperwork system, not to the factory floor, and no production plan can compress it.
On a standard kitchen run, the stages overlap and run back-to-back, which is how the committed 10-14 days holds. On a custom program - a hotel, a multi-unit dealer order, an OEM profile build - the same allowances are what the project manager schedules against, and the honest answer to how long do custom cabinets take at that scale is: it is quoted per project, with staged delivery available.
What moves the schedule - and who controls it

| Segment | Controlled by | What moves it |
|---|---|---|
| Shop drawings and approval | You | How fast you review and approve; the allowance is 1-5 days |
| Sample stage | Shared | 7-10 days from sketch to a 1:1 sample on your bench |
| Production stages | Factory | Slot booking, material prep pulled ahead of breakdown |
| Export documentation | Shared | Inspection filing runs 1-7 days on the paperwork system |
| Ocean transit | Carrier | Sailing schedules, port congestion, holiday peaks |
The buyer-controlled rows are the ones worth staring at. A program that sits four days in drawing approval has pushed its own delivery by four days, and no factory promise was broken to cause it. The frozen-spec guide exists precisely because late spec changes are the most common self-inflicted delay: every change to board, colour, banding or hardware is a new version and a new approval cycle, not a quiet edit.
The ocean segment

Once the container seals, the published transit numbers apply as part of the DDP service: 18-22 days to the US West Coast and Vancouver, 32-40 days to the US East Coast, 15-20 days to Sydney. Those numbers carry the freight, import duties, customs clearance and drayage inside them. The tariff and border guide covers what happens at each border; the scheduling point is simpler - the sailing you get depends on when the container is sealed relative to the carrier's weekly schedule, which is why the packing and documentation stages above are run back-to-back with inspection rather than after it.
The calendar risk: Chinese New Year
One date moves every schedule made in China. Chinese New Year 2026 falls on 17 February, and 2027 on 6 February - the dates are published years ahead (timeanddate). The official public holiday is about a week, but the real gap is longer: most factories wind down in the week before, stay closed for two to three weeks as workers travel home, and take another one to two weeks to return to full output. Plan around an effective gap of roughly five weeks, not seven days (Wikipedia has the background on why the date moves each year).
Two second-order effects matter to importers. First, freight rates spike in the four weeks before the holiday as every factory races to ship, and space tightens with them - the Freightos index shows the pattern every year. Second, the post-holiday backlog stretches port handling, so a container that sails right after the holiday can sit longer at origin. The practical rule: confirm orders and lock production slots by early December, and treat any program that would sail in the first three weeks of February as a January decision.
How to protect your date
- Get the production slot confirmed in writing before the deposit - it is the published policy, and it converts a promise into a schedule.
- Freeze the spec before drawings start. Late changes restart the approval clock, not just the drawing.
- Order samples in parallel with slot booking, not after. The 7-10 day sample stage only delays the program if it is run sequentially.
- Plan the calendar around Chinese New Year if your delivery window lands in January or February.
- Book your third-party inspection (SGS, Intertek or BV) when packing starts, so the inspector is on site the day the run is assembled - not a week later, with the container already sealed.
If you are working backwards from an opening date, the first 90 days guide walks the full timeline from first contact to a restocked container, and the MOQ guide explains how order size interacts with the schedule. For a program-specific answer to how long do custom cabinets take - hotel, multi-unit or OEM - send the drawings through the OEM / ODM page or contact us and the schedule comes back with the quote.
FAQ
How long do custom cabinets take from order to delivery?
Count 10-14 factory days for a kitchen or vanity run from confirmed drawings, then 18-22 days of duty-paid transit to the US West Coast or 32-40 to the East Coast. A custom profile or colour adds a 7-10 day sample stage before drawings are frozen.
How long is production after the drawings are approved?
10-14 days for kitchen and vanity programs, 12-16 days for closet and wardrobe systems. The production slot is confirmed in writing before any deposit is taken.
How long does ocean freight take?
Inside the DDP number: 18-22 days to the US West Coast and Vancouver, 32-40 days to the US East Coast, 15-20 days to Sydney. Freight, duties, clearance and drayage are included.
Does Chinese New Year affect cabinet lead times?
Yes. Factories wind down before the holiday, close for two to three weeks, and return to full output over another week or two. Confirm orders by early December if your container would sail in January or February.
How long does a sample take?
A 1:1 sample from your sketch, photo or a reference door ships in 7-10 days, and the sample stage carries no minimum. A painted sample of your actual colour ships with the first quote.
Can production be rushed?
Material prep can be pulled ahead of breakdown on urgent jobs, and parallel sample work saves a week. Trial assembly, inspection and the export filing cannot be compressed - the filing alone runs 1-7 days on the paperwork system.
